Amazon could sell and rent back $8bn of Nvidia chips

Amazon has held talks with investors on selling about $8bn of Nvidia Grace Blackwell chips to a special-purpose vehicle and leasing them back, the Financial Times reported on 2 October 2026. Amazon plans to offer an equity stake of up to 10% in the vehicle.

Editorial collage headed Amazon, with a tall rack of Nvidia servers on a hand truck as if being wheeled away, a price tag reading $8bn, and the Amazon and Nvidia logos; the subtitle reads $8bn chip leaseback talks.

Listen to this articleListen

Amazon has held talks with investors on selling about $8 billion of Nvidia Grace Blackwell chips to a special-purpose vehicle and then leasing them back, the Financial Times reported on 2 October 2026. The vehicle would raise money from outside investors by issuing debt, and Amazon plans to offer an equity stake of up to 10% in it, the FT said.

Amazon and Nvidia did not immediately respond to Reuters for comment. The chips were bought or leased by Amazon and are installed in more than a dozen US data centres across five states, including Nevada and Virginia, according to the report. Amazon expects to spend about $220 billion on capital projects this year.

How would the sale and leaseback work?

A special-purpose vehicle would buy the chips from Amazon with money borrowed from outside investors, and Amazon would then lease them back, the FT reported on 2 October 2026. Amazon has held talks with investors in recent weeks to gauge interest in a deal that would move thousands of Grace Blackwell chips it is installing in US data centres into the vehicle, Reuters said, citing the FT.

In a sale and leaseback, the seller turns an asset into cash and pays rent to keep using it. Amazon could take a more asset-light approach to its balance sheet by passing the expensive chips to investors, the FT said.

An animation in five steps showing how Amazon's reported chip leaseback would work, with three boxes stacked on the right: outside investors, a special-purpose vehicle and Amazon. Step 1: Amazon holds Grace Blackwell chips in more than a dozen US data centres across five states. Step 2: outside investors lend to the new vehicle, and Amazon plans to offer an equity stake of up to 10% in it. Step 3: one arrow carries about $8bn of chips from Amazon to the vehicle and another carries cash back to Amazon. Step 4: the vehicle leases the chips to Amazon, which keeps running them and pays rent. Step 5: what the FT says Amazon is after, a stronger, more asset-light balance sheet.
The reported structure in five steps: Amazon holds the chips, investors fund a vehicle, the vehicle buys about $8 billion of chips and Amazon leases them back. Drawn from the Financial Times report of 2 October 2026, as carried by Reuters.

Grace Blackwell is Nvidia’s design that pairs two Blackwell GPUs with one Grace CPU on a single module. AWS, Amazon’s cloud arm, rents systems built from it to customers as EC2 P6e UltraServers, with up to 72 Blackwell GPUs in one NVLink domain on the GB200 version, according to AWS.

Amazon expects to spend about $220 billion this year

Amazon expects to spend about $220 billion on capital projects in 2026, chief executive Andy Jassy told investors on 30 July, up from an earlier estimate of $200 billion because memory costs more, Fortune reported. Jassy said demand would still outrun the capacity Amazon can add this year, and expected the same in 2027. AWS remains on pace to double its power capacity by the end of 2027 compared with 2025, he said. AWS, the business that rents out the computing, grew sales 37% to $42.2 billion in the second quarter, with operating income of $16.6 billion, and its AI business passed an annual revenue run rate of $25 billion, Amazon said.

The spending has pushed Amazon’s free cash flow below zero. In the twelve months to 30 June 2026 its operations brought in $161.4 billion and it spent $169.0 billion on property and equipment, after proceeds from sales and incentives, leaving an outflow of $7.6 billion, its second-quarter results show. Amazon says the $66.1 billion rise in that spending over the year primarily reflects investment in artificial intelligence. Cash capital expenditure in the first half of 2026 was $96.3 billion, against $55.6 billion a year earlier, its quarterly filing shows.

Twelve months to Cash from operations Spent on equipment, net Free cash flow
30 June 2025 $121.1bn $103.0bn $18.2bn
30 June 2026 $161.4bn $169.0bn −$7.6bn

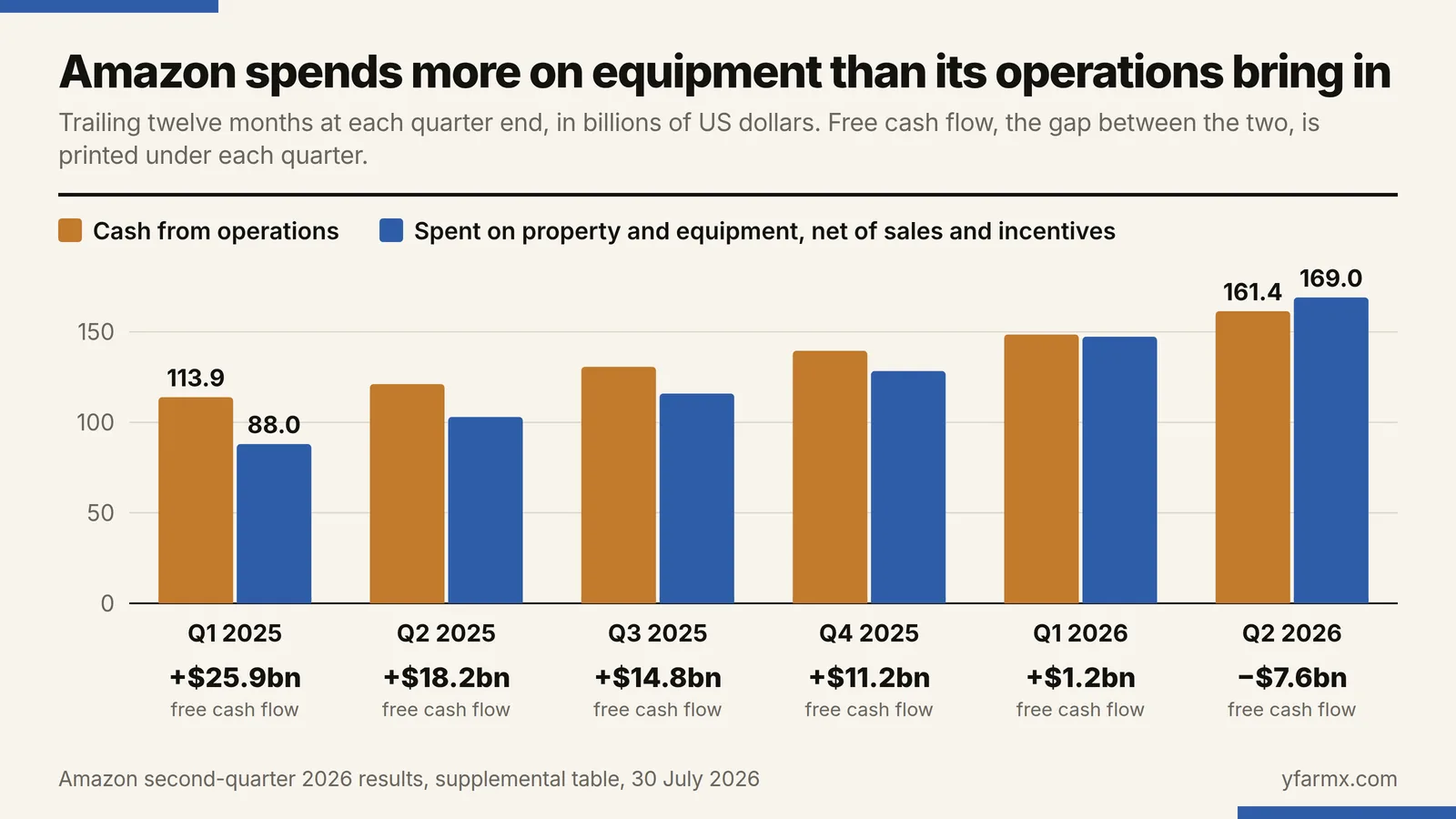

Bar chart headed Amazon spends more on equipment than its operations bring in, showing trailing twelve-month figures in billions of US dollars at six quarter ends. Cash from operations, in amber, rises from 113.9 at Q1 2025 to 161.4 at Q2 2026. Spending on property and equipment net of sales and incentives, in blue, rises faster, from 88.0 to 169.0, and passes operating cash in the last quarter. Free cash flow, printed under each quarter, falls from plus $25.9bn to plus $18.2bn, $14.8bn, $11.2bn and $1.2bn, then to minus $7.6bn at Q2 2026.
Amazon's cash from operations against its spending on property and equipment, trailing twelve months at each quarter end from March 2025 to June 2026, from the supplemental table in its second-quarter results of 30 July 2026. Source: Amazon. Select the chart to enlarge.

Amazon’s long-term debt nearly doubled in six months

Amazon’s long-term debt rose from $68.8 billion at the end of 2025 to $133.0 billion on 30 June 2026, at face value, its quarterly filing shows. Amazon sold notes in dollars, euros, Swiss francs and Canadian dollars in the first half, including $37.0 billion of dollar notes in March, and agreed a $17.5 billion delayed-draw term loan in June, undrawn at 30 June.

Amazon has kept borrowing since. It sold $25.0 billion of dollar notes on 9 July and £4.25 billion of sterling notes on 14 September, about $5.63 billion at the Federal Reserve’s H.10 rate of $1.3250 to the pound for 25 September 2026. The vehicle the FT describes would carry its own debt, raised from outside investors.

Date What Amount
31 December 2025 Long-term debt, face value $68.8bn
30 June 2026 Long-term debt, face value $133.0bn
9 July 2026 New dollar notes $25.0bn
14 September 2026 New sterling notes £4.25bn, about $5.63bn

Who else rents AI hardware from investors?

xAI does: in January 2026 Apollo led a $3.5 billion financing for Valor Compute Infrastructure, a fund managed by Valor Equity Partners that acquires Nvidia GB200 chips and leases them to a subsidiary of Elon Musk’s xAI. The money supports the fund’s $5.4 billion acquisition and lease of computing equipment on a triple net lease, and Nvidia invested in the fund as an anchor limited partner, Apollo said. Musk put xAI’s Colossus 2 supercomputer at 550,000 Nvidia chips on 25 September.

Meta has used a venture for a whole campus. Funds managed by Blue Owl Capital own 80% of the venture developing Meta’s Hyperion data-centre campus in Louisiana, with Meta keeping 20% and receiving a one-time distribution of about $3 billion, Meta said on 21 October 2025. Meta’s leases on the campus start in 2029, it keeps the venture off its consolidated accounts, and its maximum exposure to loss was $46.03 billion on 30 June 2026, its quarterly filing shows.

Deal Who holds the asset Size What it holds
Amazon, reported talks, 2 October 2026 A special-purpose vehicle about $8bn Grace Blackwell chips in Amazon’s US data centres
xAI, 7 January 2026 Valor Compute Infrastructure $5.4bn, with $3.5bn led by Apollo Nvidia GB200 chips leased to an xAI subsidiary
Meta, 21 October 2025 A venture 80% owned by Blue Owl funds about $27bn of development costs The Hyperion campus in Louisiana

Chipmakers are putting money into their buyers too: AMD agreed on 22 July 2026 to make an equity investment of up to $5 billion in Anthropic, which will deploy up to 2 gigawatts of AMD chips.

AWS rents Grace Blackwell systems out by the hour

AWS sells time on Grace Blackwell hardware through its EC2 P6e UltraServers, built on Nvidia’s GB200 NVL72 and GB300 NVL72 systems, its product page shows. On 2 October 2026 AWS’s price list quoted $761.904 an hour, or $10.582 per accelerator, for a 72-GPU P6e-GB200 UltraServer reserved through EC2 Capacity Blocks in its Dallas Local Zone.

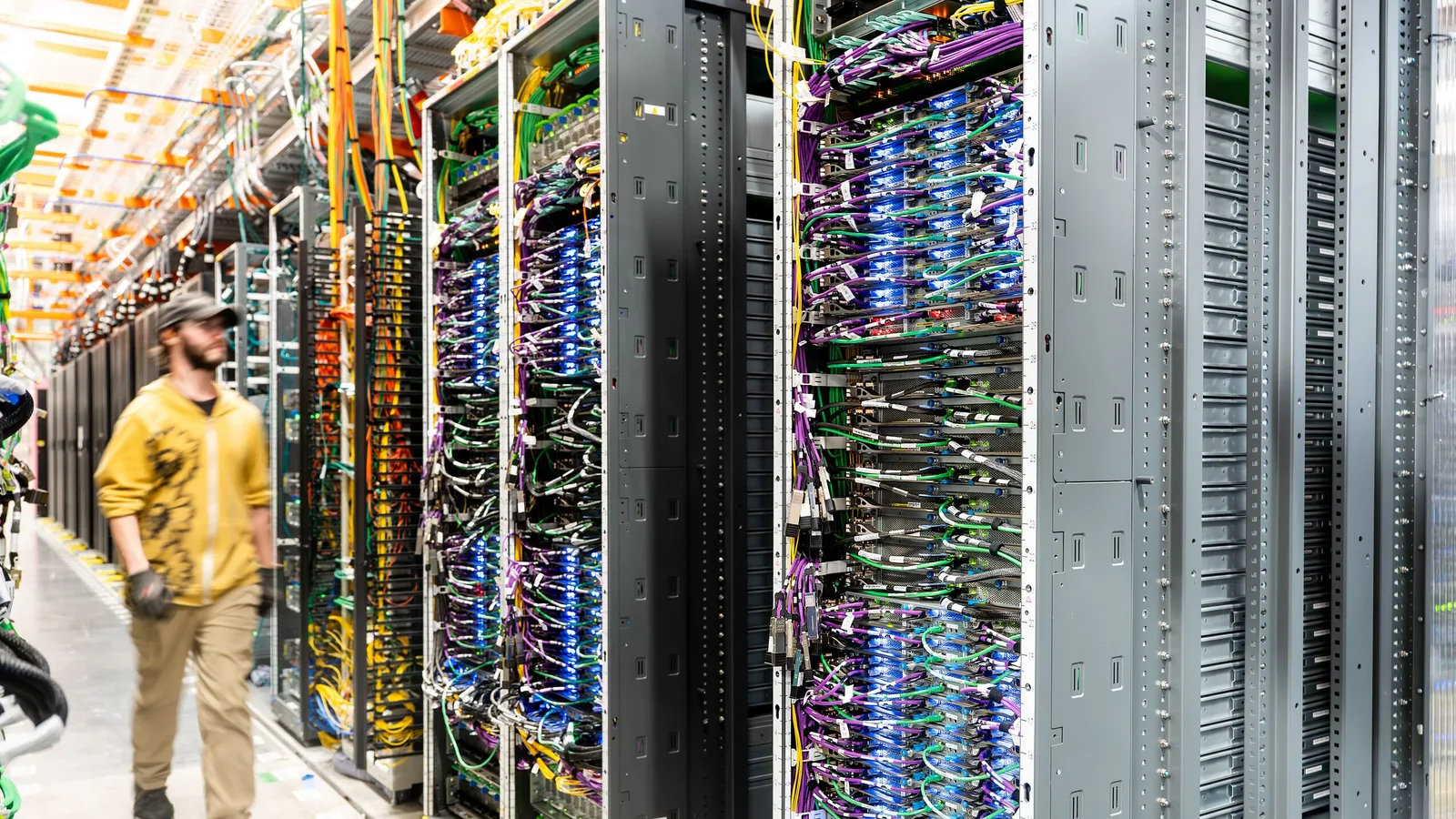

Photograph of an AWS engineer in a yellow jacket and cap walking along an aisle of tall black server racks, their fronts packed with blue, purple and green network cables, under yellow cable trays and bright overhead lights.
An AWS engineer walks past server racks in one of Amazon's data centres. Amazon published the photograph on 11 June 2025 with its account of the liquid cooling AWS built for denser AI chips. Source: Amazon.

Questions people ask

What is Amazon's reported chip sale and leaseback?
Amazon has held talks with investors about moving about $8 billion of Nvidia Grace Blackwell chips into a special-purpose vehicle that would buy them and lease them back to Amazon, the Financial Times reported on 2 October 2026. The vehicle would raise money from outside investors by issuing debt, and Amazon plans to offer an equity stake of up to 10% in it. The chips sit in more than a dozen US data centres across five states.
Why would Amazon sell chips it still uses?
The FT said the aim is a stronger, more asset-light balance sheet. Amazon expects about $220 billion of capital spending in 2026, chief executive Andy Jassy told investors on 30 July, and its free cash flow for the twelve months to 30 June 2026 was an outflow of $7.6 billion, against an inflow of $18.2 billion a year earlier. Its long-term debt rose from $68.8 billion to $133.0 billion in the first half of 2026.
Has anyone financed AI chips this way before?
Similar structures exist. In January 2026 Apollo led a $3.5 billion financing for Valor Compute Infrastructure, a fund managed by Valor Equity Partners, to support its $5.4 billion acquisition and lease of computing equipment, including Nvidia GB200 chips, to a subsidiary of Elon Musk's xAI. That fund acquires chips to lease out, while Amazon would sell chips it is already installing. Meta uses a related structure for buildings: funds managed by Blue Owl Capital own 80% of the venture developing its Hyperion data-centre campus in Louisiana.
